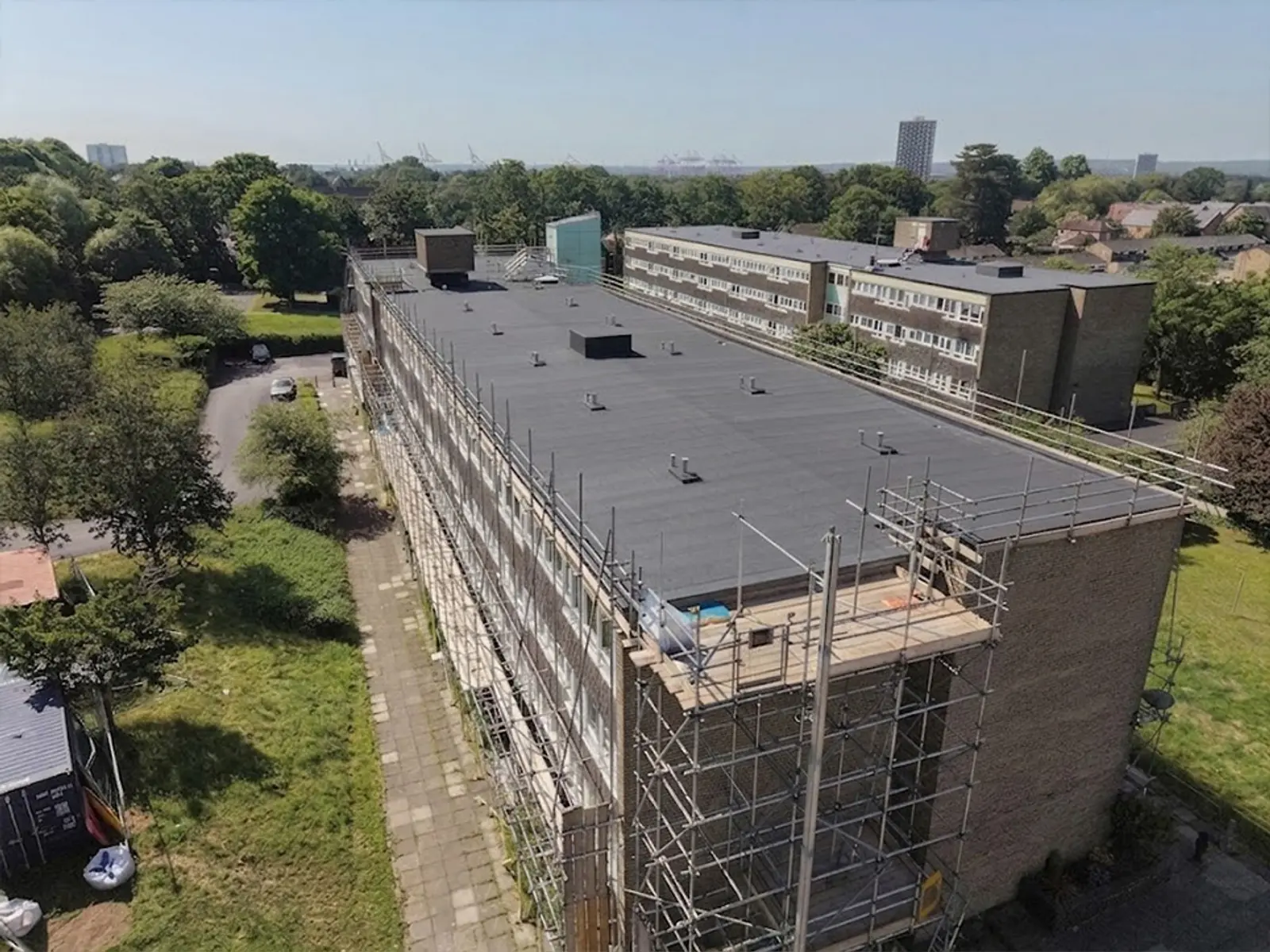

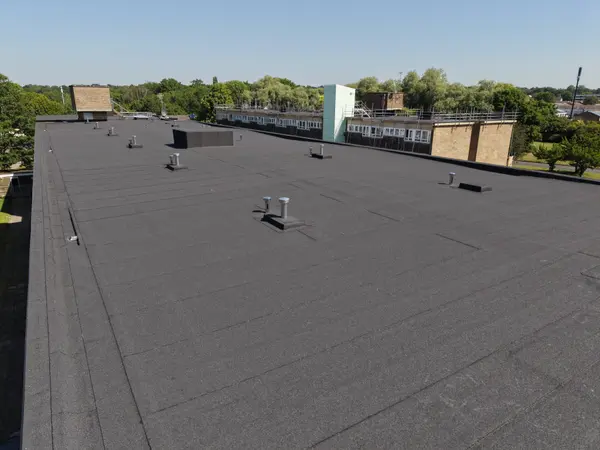

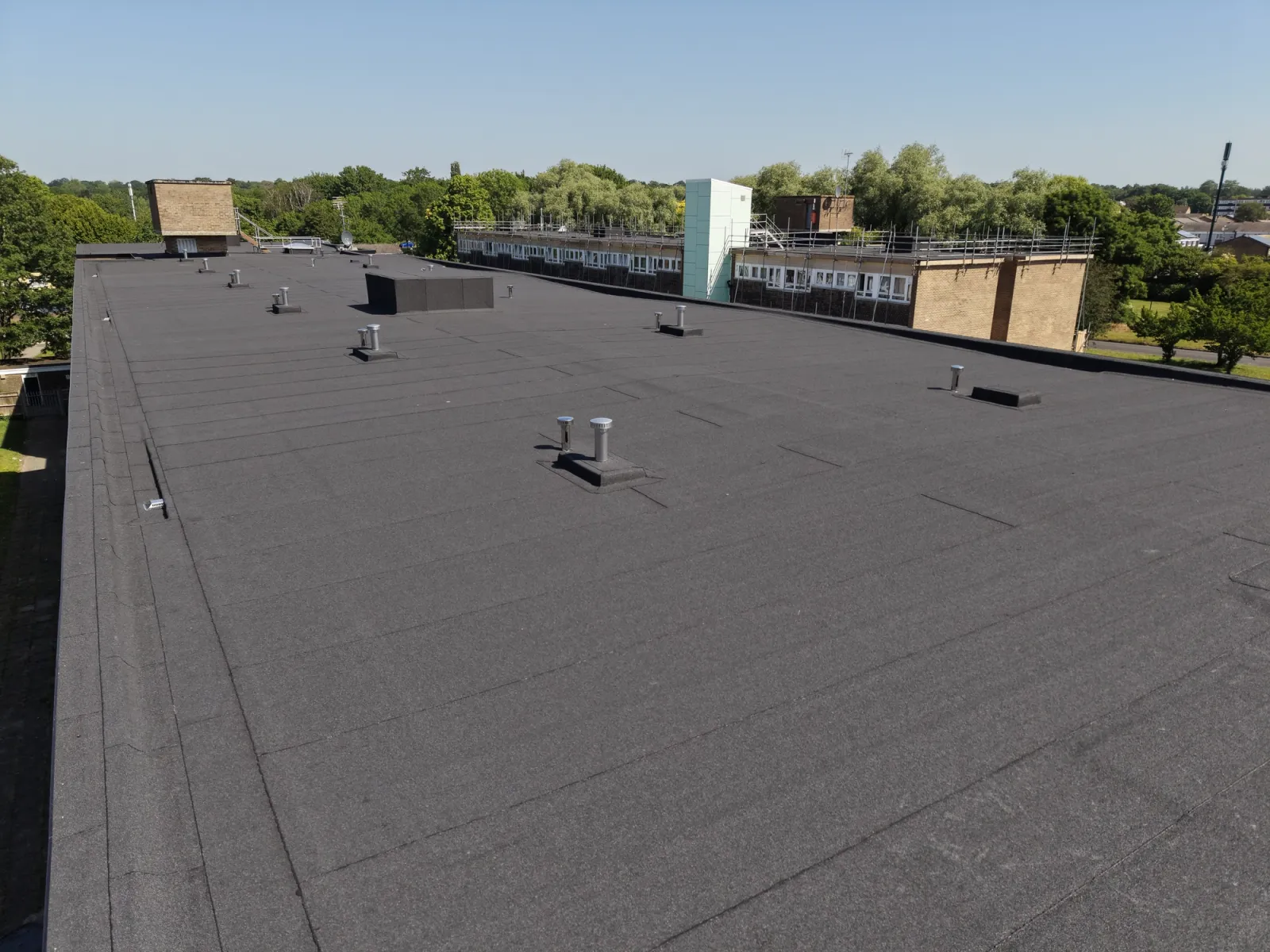

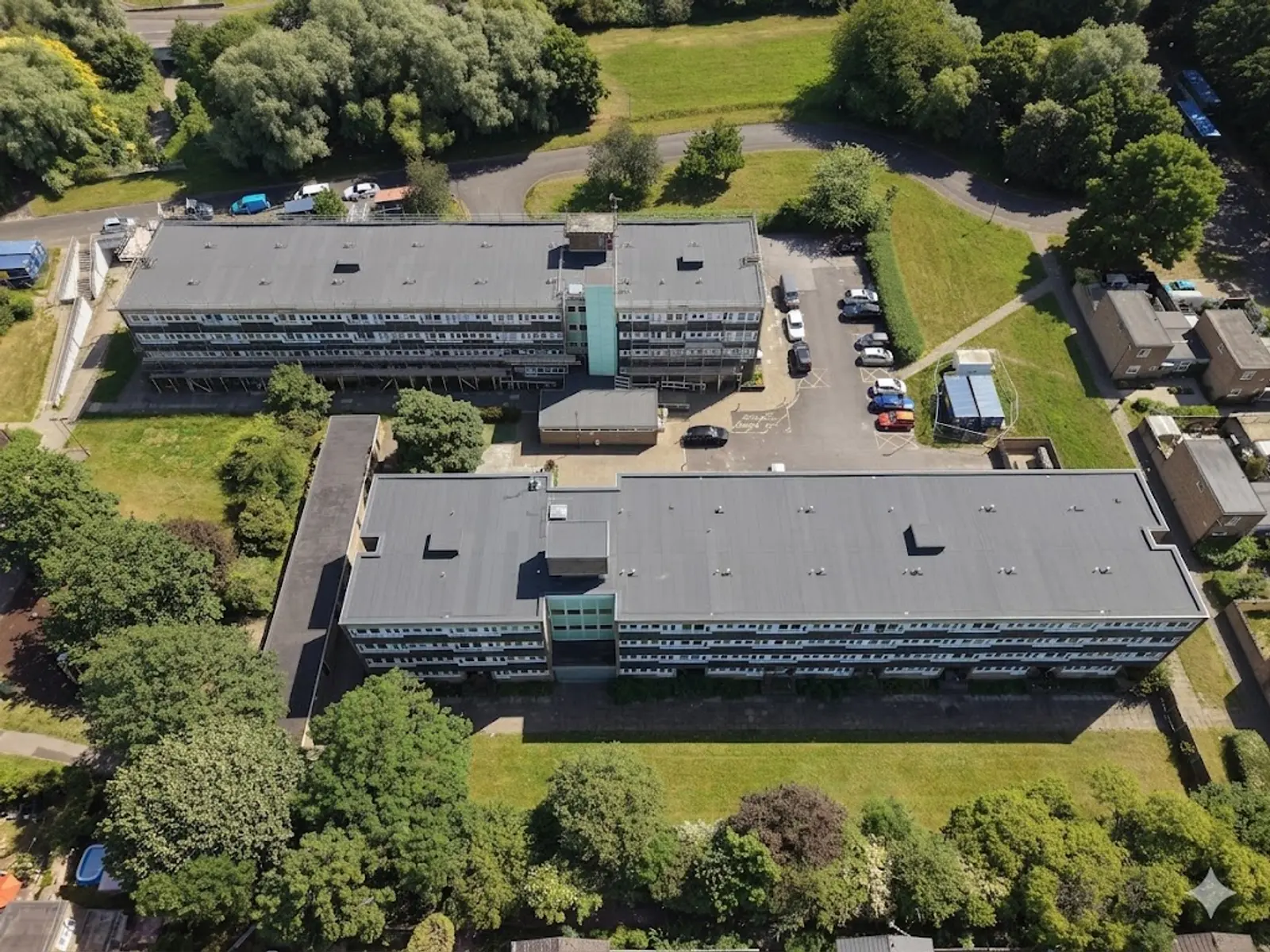

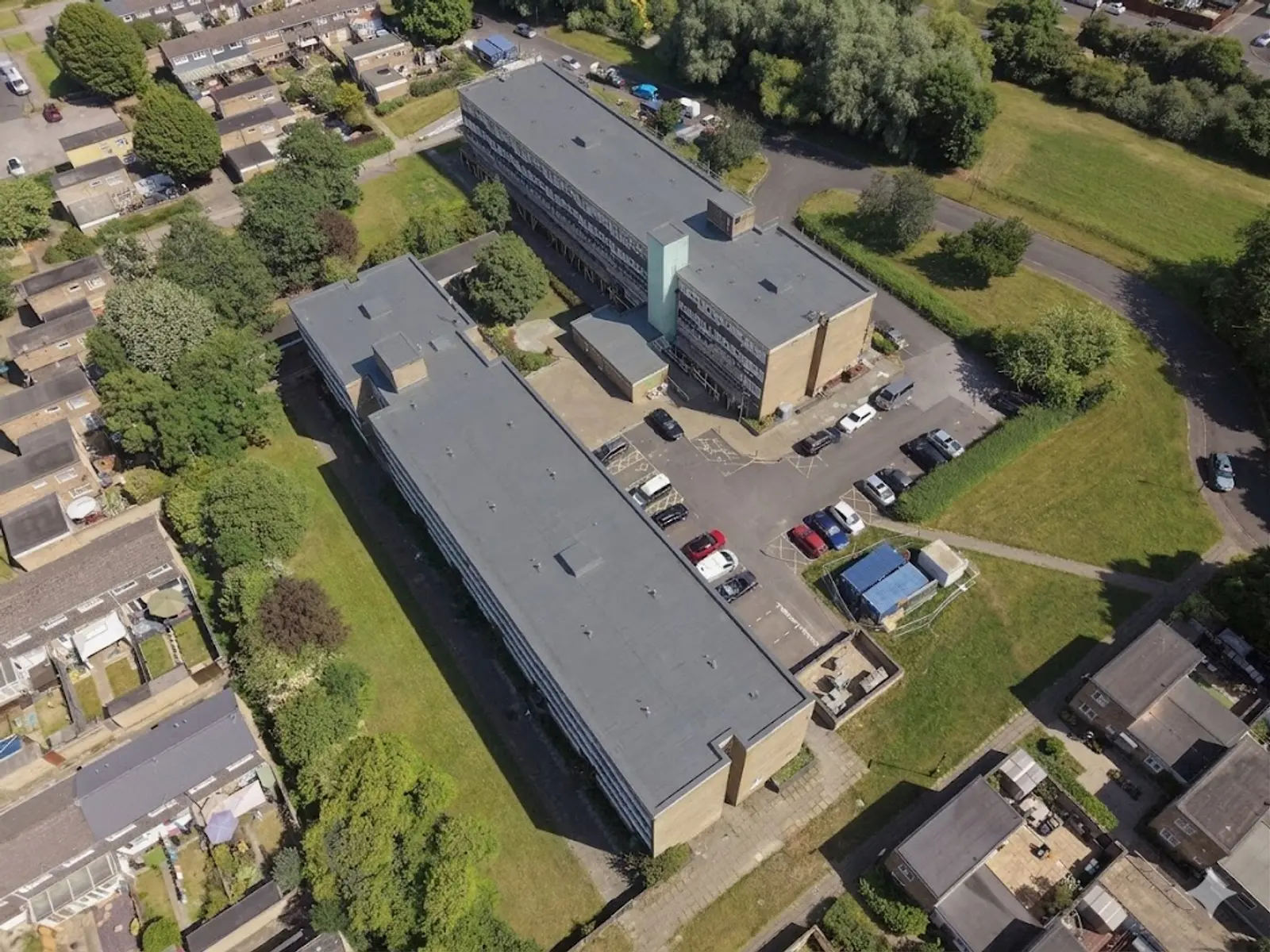

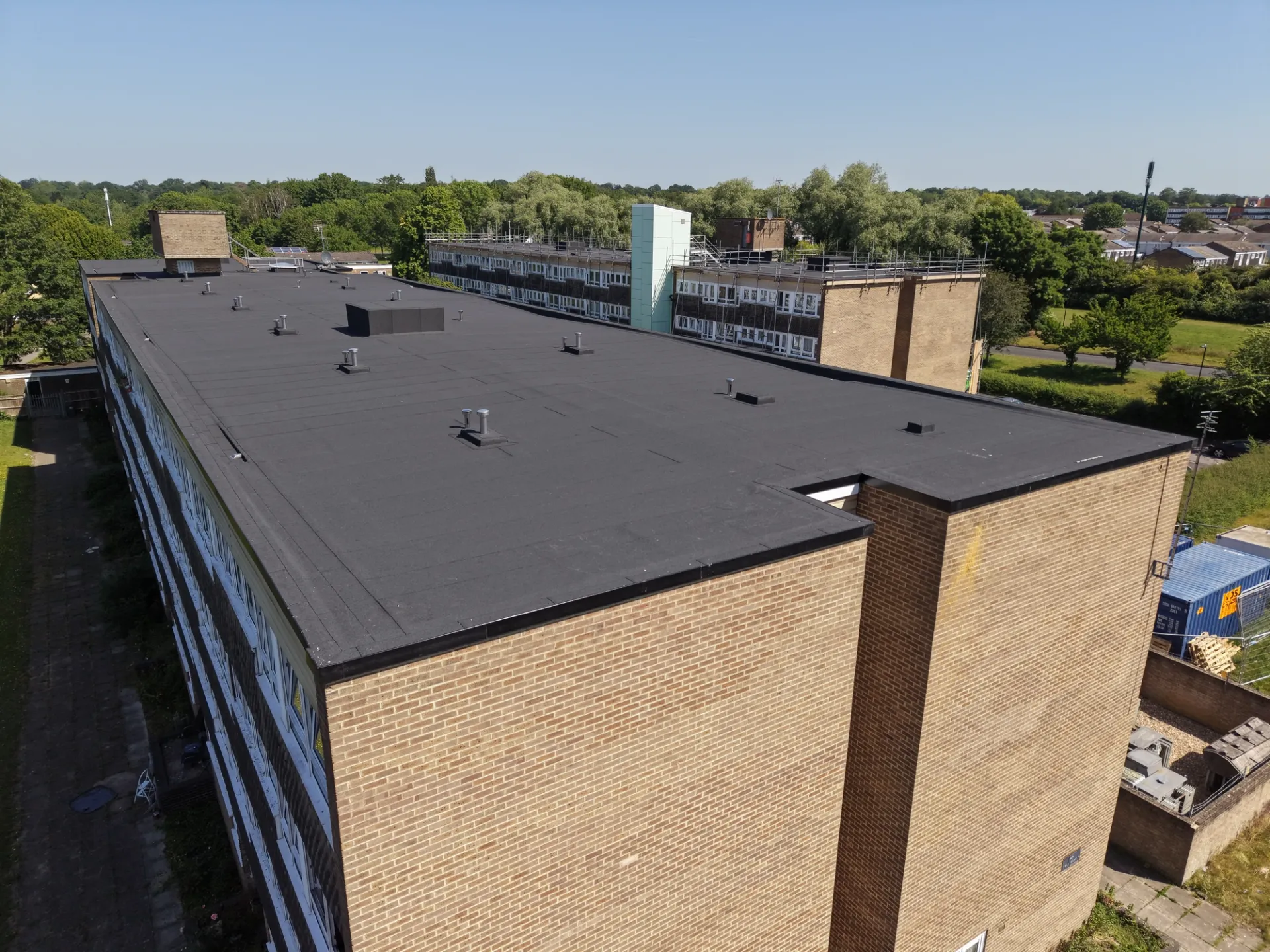

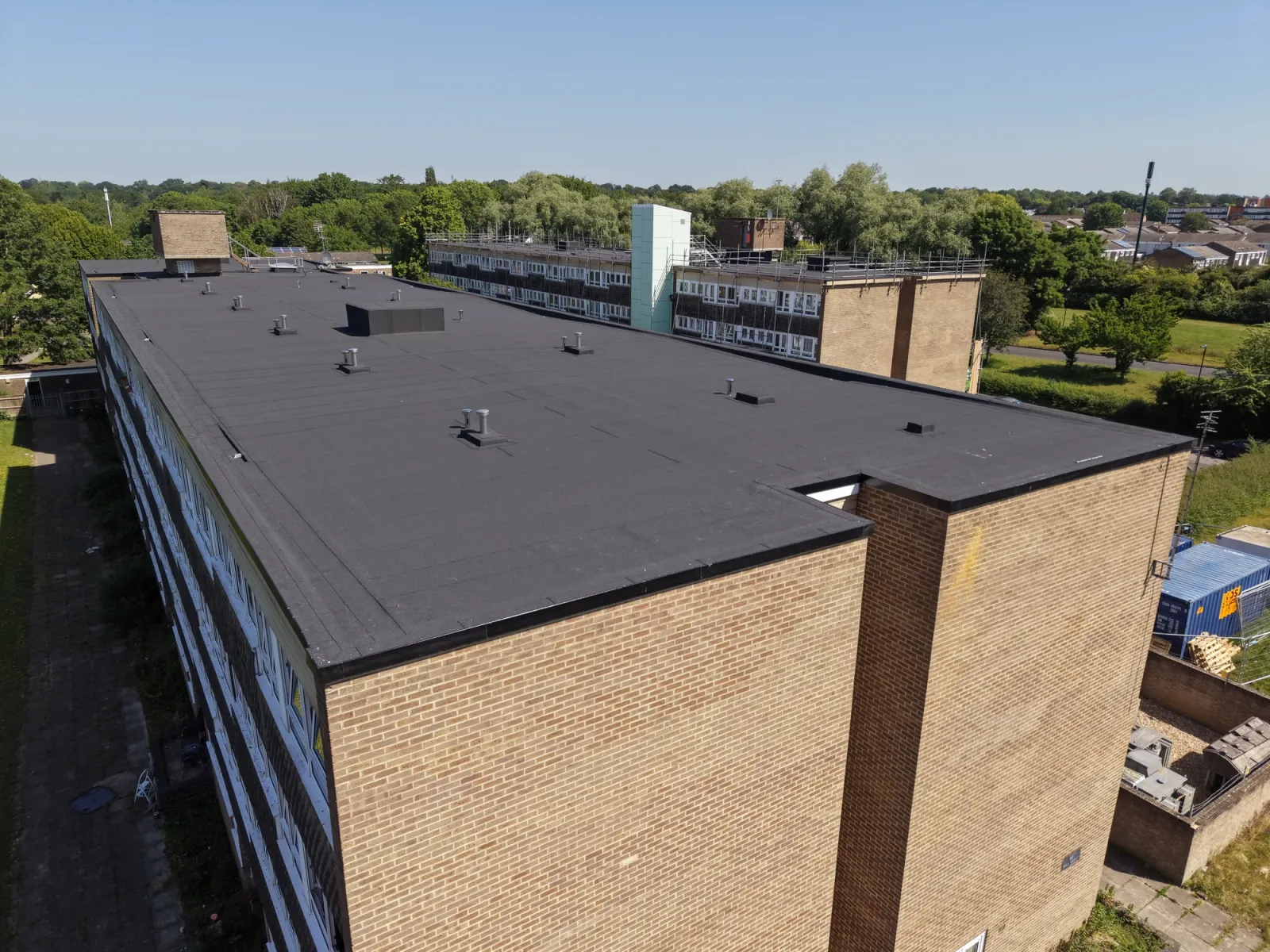

Case Study
Southampton, Hampshire SO16 9QD

Rozel Court — Soprema Flat Roof Waterproofing Overlay

Southern Projects completed a comprehensive flat roof overlay system at Rozel Court, Southampton, covering 124 residential flats across two blocks. The project involved installing a Soprema reinforced bitumen waterproofing system with 25-year warranty, achieving enhanced thermal performance with a U-value of 0.15W/m²K.

Client

Trident Maintenance Services Ltd

Year

2026

Sector

Residential

Key highlights

  • Soprema Sopralene reinforced bitumen waterproofing system with BBA certification
  • Enhanced thermal performance achieving 0.15W/m²K U-value
  • 25-year manufacturer warranty providing long-term performance assurance
  • Safe2Torch protocols ensuring fire safety during torch-on installation
  • Minimal disruption approach maintaining full residential occupancy

Roof Area

1,787 m²

Properties

124 flats

U-Value

0.15 W/m²K

Warranty

25 years

About the project

Project overview

Rozel Court in Southampton comprises a 124-flat residential development requiring comprehensive roof renewal across two distinct blocks. The existing concrete deck structure needed a robust overlay solution to provide long-term waterproofing and improved thermal efficiency for this multi-occupancy residential estate in the SO16 postcode area.

Southern Projects was commissioned to deliver a complete flat roof overlay system while maintaining full occupancy of the residential units below. The works required careful coordination with tenants, restricted working hours (08:00-16:00 weekdays, 08:00-14:00 Saturdays), and comprehensive exclusion zones to minimise disruption. Safe2Torch protocols were implemented throughout, with wind speed monitoring using anemometers and work suspension when speeds exceeded 28mph.

The technical solution centred on the Soprema Sopralene waterproofing system, installed by Southern Projects as an approved contractor. The build-up comprised Sopradere Quick primer, Sopravap Eva35 air and vapour control layer, Efyos Blue A insulation, and a two-layer waterproofing membrane system. The first layer utilised Soprastick Venti FF self-adhered bonding, topped with Sopralene Flam 250 AF torch-on capsheet in black slate finish.

Installation progressed systematically across both blocks using scaffold access and hoist systems for material handling. All torch-on work followed NFRC Safe2Torch guidelines, with comprehensive RAMS covering working at height, material handling, and tenant liaison protocols. The existing roof substrate was surveyed and prepared to BS 6229:2025 standards before overlay installation commenced.

The completed installation achieved the target U-value of 0.15W/m²K and carries BBA Certificate 95/3098 accreditation. Final inspections confirmed all snags addressed, with handover completed to Trident Maintenance Services and sign-off documented for both block phases. The Soprema system provides 25-year warranty coverage, offering long-term performance assurance for the residential estate.

The Challenge

Delivering comprehensive roof overlay across 124 occupied residential flats while maintaining tenant safety and minimising disruption, requiring careful coordination of access, materials handling, and weather-dependent torch-on installation work.

Our Approach

Systematic phased installation using approved Soprema contractors, Safe2Torch protocols for fire safety, scaffold access with hoist systems, and strict working hour restrictions to accommodate residential occupancy throughout the project duration.

Results & Outcomes

Successful completion of both blocks with enhanced thermal performance (U-value 0.15W/m²K), 25-year warranty coverage, and full handover achieved with all identified snags addressed and final inspections completed.

Timeline

01

Project Setup

RAMS development, Safe2Torch assessment, and scaffold installation

02

Block 1-62 Installation

Soprema waterproofing system installation and completion

10-12 weeks

03

Final Handover

Final inspections, snag resolution, and project sign-off
