Stenball Group — Bricklayers Arms urgent roof repairs
Southern Projects delivered urgent pitched roof repairs at Bricklayers Arms for Stenball Group Limited, addressing high-severity defects identified in a condition survey. Works included repointing ridge and hip tiles, replacing an existing rooflight with a Velux unit, and sealing critical openings between slate and flat roof junctions.
Client
Stenball Group Limited
Year
2025
Sector
Commercial
Services
Key highlights
- Urgent repairs to high-severity roof defects identified in condition survey
- Ridge and hip tile repointing with matching mortar specification
- Complete rooflight replacement with Velux unit and frame modifications
- Critical junction sealing using lead and mortar combination
- Full NASC-compliant scaffolding and weather monitoring protocols
Duration
1–2 weeks
Value
£2,595.75
R2/R7/R10 items
3
Site hours
08:00–16:00 Mon–Fri
About the project
Project overview

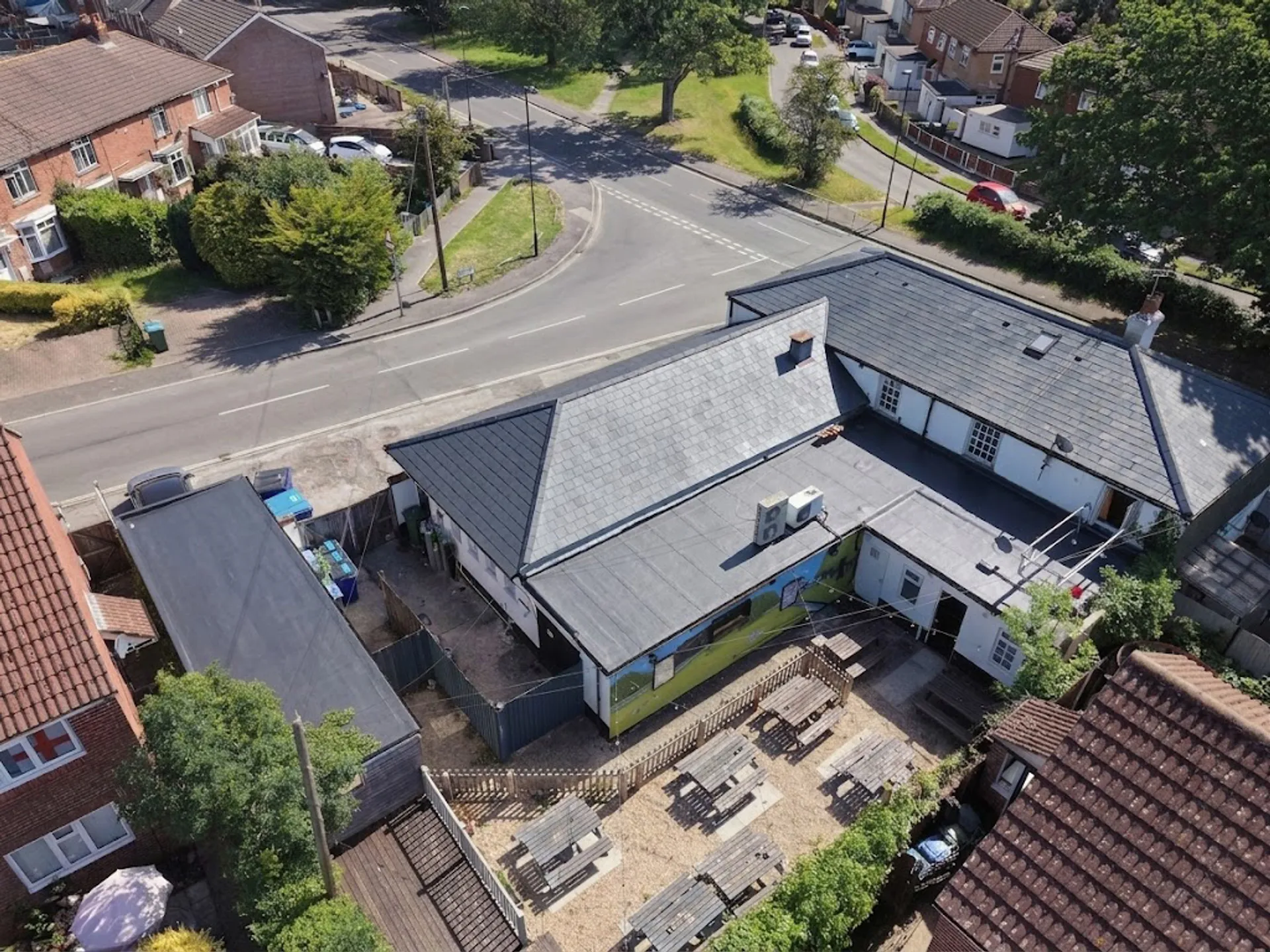

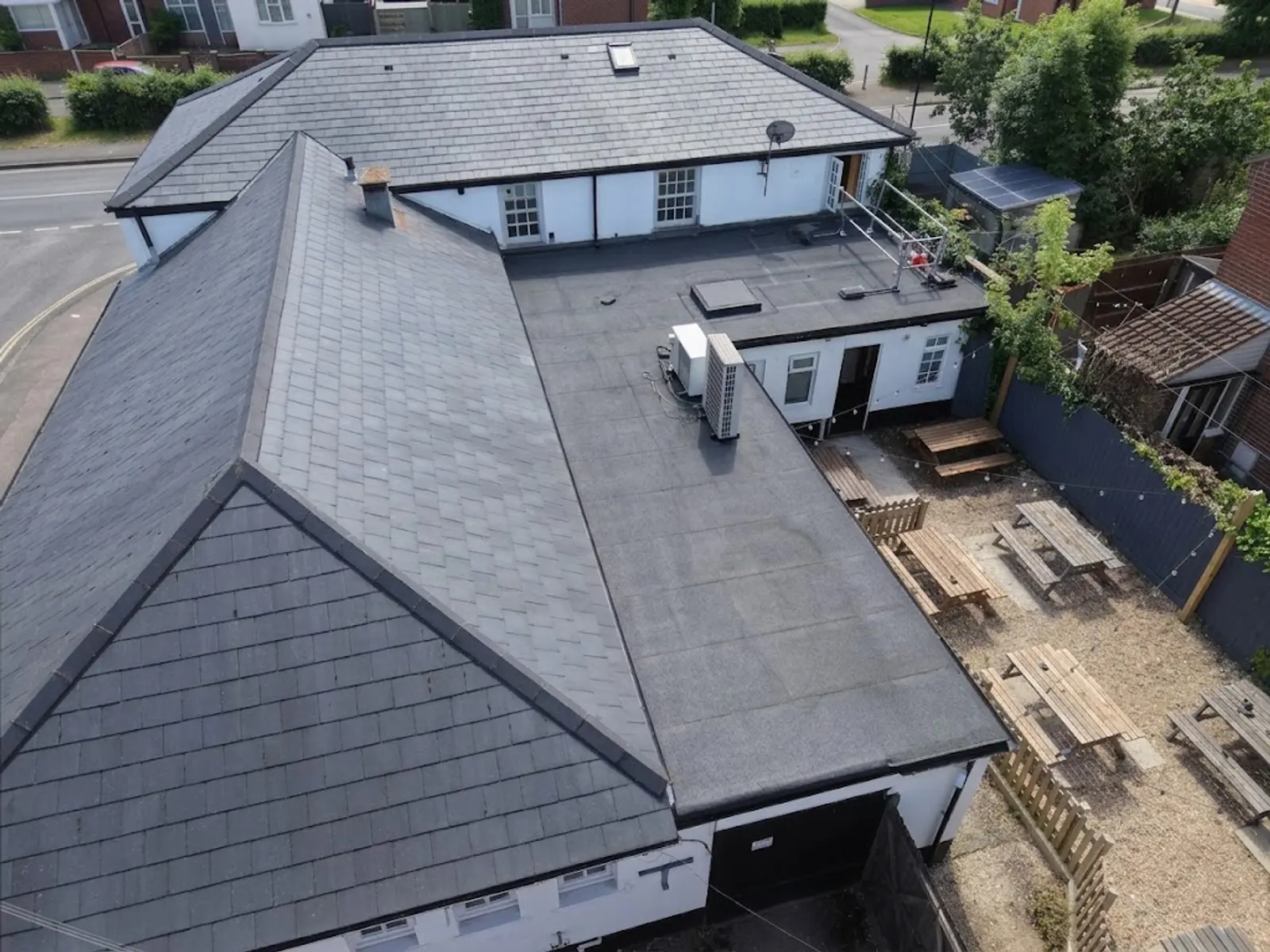

The Bricklayers Arms property on Wimpson Lane, Millbrook required immediate intervention following a comprehensive roof survey that identified several high-severity defects threatening the building's weathertightness. Located in Southampton's SO16 postcode area, this commercial property presented typical challenges of an aging pitched roof system where deferred maintenance had created multiple failure points requiring coordinated repair works.
The commissioned scope targeted three critical items classified as R2, R7, and R10 in the condition report: repointing deteriorated ridge and hip tiles, complete rooflight replacement, and sealing a problematic opening between the slate roof and adjacent flat roof junction. Operational constraints included limiting works to 08:00-16:00 hours Monday to Friday with no weekend activity permitted, while maintaining safe access protocols and coordinating with existing tenants to minimise disruption.
The technical approach commenced with comprehensive scaffolding installation complying with NASC guidance TG20:21 and SG4:22 standards, providing secure perimeter access around the property. Ridge and hip tile repointing involved carefully removing all moss and deteriorated mortar before applying a matching mortar mix to restore weatherproofing integrity. The existing rooflight replacement utilised a Velux unit or equivalent specification, requiring frame alterations to accommodate the new installation and ensure proper integration with the surrounding slate covering.
Critical to the project's success was addressing the opening between slate and flat roof junction using a combination of lead work and mortar application—a detail requiring precise execution to prevent future water ingress. All works proceeded under strict wind speed monitoring protocols, with activities suspended when readings exceeded 28 mph as measured by anemometer. The method statement emphasised potential asbestos presence awareness, implementing Control of Asbestos Regulations 2012 precautions throughout the repair sequence.
Project delivery utilised a skilled operative team including specialist roofers and support personnel, with material procurement through established suppliers including SIG Roofing. The works generated total project costs of £2,595.75 covering labour, materials, and associated contractor services. Upon completion, all waste materials were removed from site and scaffolding dismantled with appropriate reinstatement works completed as specified in the original scope agreement.
The Challenge
Multiple high-severity roof defects threatened building weathertightness, including deteriorated ridge and hip tile pointing, failed rooflight, and critical opening between slate and flat roof junction requiring immediate repair to prevent further deterioration.
Our Approach
Systematic repair programme utilising NASC-compliant scaffolding, matching mortar specifications for repointing works, Velux rooflight replacement with frame modifications, and combination lead/mortar sealing of critical junctions under strict weather monitoring protocols.
Results & Outcomes
Successfully completed all urgent repairs within the specified timeframe, restoring roof weathertightness and structural integrity while maintaining operational constraints and safety protocols throughout the £2,595.75 project delivery.
Timeline
01
Site setup and scaffolding
NASC-compliant scaffolding installation and safety zone establishment
2-3 days
02
Ridge and hip repointing
Moss and mortar removal, repointing with matching mortar mix
3-4 days
03
Rooflight replacement
Existing unit removal, frame modification, Velux installation
2 days
04
Junction sealing and completion
Lead and mortar application to opening, waste removal, reinstatement
2-3 days
